Brookings Paper Puts the AI Build-Out at $10.3 Trillion

A Brookings Papers on Economic Activity conference draft by Columbia real estate professor Stijn Van Nieuwerburgh, posted September 23 for presentation September 25, projects $10.3 trillion of U.S. AI infrastructure investment from 2025 to 2032, about 3.63 percent of GDP a year, and warns that the financing is moving into leases, joint ventures and special-purpose vehicles that are hard to see.

BY EDITED BY ZED TRUONG10 MIN READ
SHARE

Direct answer

Direct answer to Financing the AI Buildout Brookings

The headline is scale: $10.3 trillion over 2025 to 2032, larger relative to GDP than the railroad, highway or telecom booms. The CRE story is structure. The paper documents data center shells and power moving off hyperscaler balance sheets into leased, highly leveraged project vehicles, with tenant concentration, obsolescence and residual value risk sitting with landlords and lenders. It says systemic risk is not yet established.

A daylight photograph under a pale overcast sky of a long, windowless hyperscale data center building clad in grey, silver and pale green metal panels, stretching away to the left toward a loading dock and a line of conifers, with a smaller brown single-storey electrical building behind a chain-link fence and gate at right, a lattice transmission mast and part of a substation at the far right edge, a gravel path and low bollard lights crossing a patchy grass and gravel lot in the foreground, and two parked cars beside the building.
IMAGE: CHRISTOPHER DOWN / CC BY 4.0Meta’s data center in Luleå, Sweden, with its on-site electrical building and substation, the shell-and-power layer that the Brookings paper says is increasingly owned by third parties and leased to hyperscalers. On September 23, 2026, Brookings posted Stijn Van Nieuwerburgh’s conference draft projecting $10.3 trillion of U.S. AI infrastructure investment from 2025 to 2032. The building is shown for context and is not discussed in the paper. Image: Christopher Down / CC BY 4.0.

What Brookings published, and what the paper estimates

Brookings posted “Financing the AI buildout” on September 23, 2026, a summary and conference draft of a paper by Stijn Van Nieuwerburgh, the Earl Kazis and Benjamin Schore Professor of Real Estate at Columbia Business School. It is one of three papers on the Panel on AI and Policy at the fall 2026 Brookings Papers on Economic Activity conference, scheduled for 9:00 a.m. Eastern on Friday, September 25. The draft itself is dated September 4, 2026 and carries the standard Brookings notice that each publication represents the sole views of its author. Its central estimate is that investment in data center buildings, power systems, networking and specialized chips will total $10.3 trillion from 2025 to 2032, an average of 3.63 percent of U.S. GDP a year. The paper’s Table 1 sets that against earlier booms as average annual capital expenditure over each period: canals at 0.66 percent of GDP from 1836 to 1841, railroads at 2.24 percent from 1870 to 1890, electrification at 0.50 percent from 1905 to 1925, highways at 1.13 percent from 1956 to 1973, and telecom and fiber at 1.10 percent from 1996 to 2003. The AI figure is a projection; the others are history.

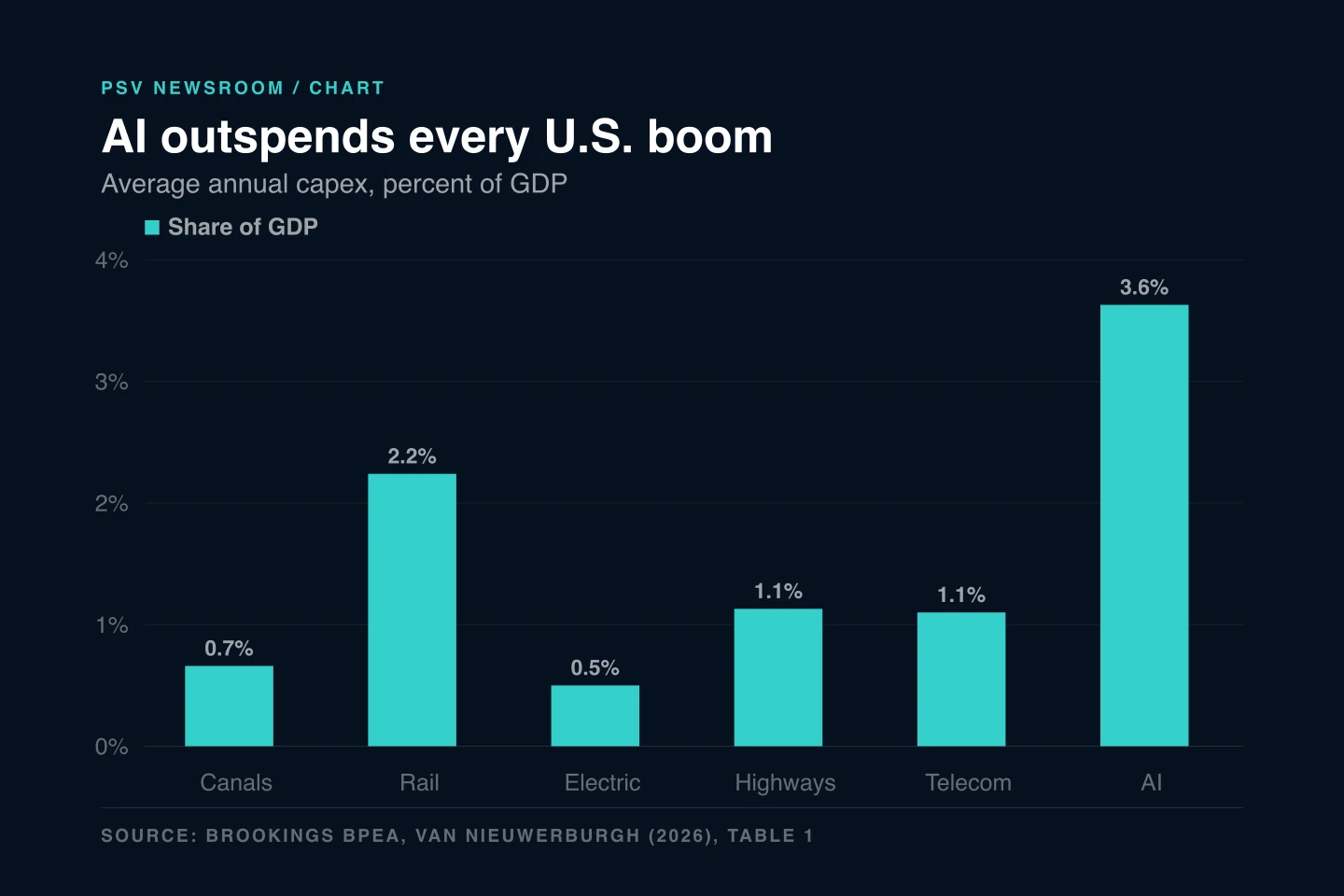

A dark PSV bar chart titled “AI outspends every U.S. boom,” subtitled “Average annual capex, percent of GDP.” Six teal bars are labelled Canals at 0.7 percent, Rail at 2.2 percent, Electric at 0.5 percent, Highways at 1.1 percent, Telecom at 1.1 percent and AI at 3.6 percent, against a vertical axis running from 0 to 4 percent. The source line reads Brookings BPEA, Van Nieuwerburgh (2026), Table 1.
PSV CHART / BROOKINGS BPEA, VAN NIEUWERBURGH (2026), TABLE 1Average annual capital expenditure as a share of GDP: canals 0.66 percent (1836 to 1841), railroads 2.24 percent (1870 to 1890), electrification 0.50 percent (1905 to 1925), highways 1.13 percent (1956 to 1973), telecom and fiber 1.10 percent (1996 to 2003), and the AI buildout 3.63 percent (2025 to 2032). The AI bar is the paper’s projection; the others are historical estimates. Chart: PSV, from Brookings BPEA, Van Nieuwerburgh (2026), Table 1.

The estimate is built bottom up, and the method is the part an operator can check. Using Cleanview project-level data from July 2026, the paper counts about 57 GW of operating U.S. data center capacity and a planned pipeline of about 509 GW, which it says plainly is not a completion forecast. Its central scenario completes 182.8 GW during 2025 to 2032, including 19.0 GW tied to projects already operating in 2025 or 2026, completes a further 117.2 GW after 2032, and never builds 226.9 GW. Setting aside the 19.0 GW already operating, the remaining three buckets sum to 507.9 GW, which computes to the paper’s approximate 509 GW pipeline. Costs come from a representative 200 MW AI training campus at roughly $8.2 billion: about $2.2 billion for the facility, $0.4 billion for incremental power infrastructure and $5.6 billion for the installed IT system, with GPU racks at $4 million each. The abstract scales that to about $41 billion per GW. On financing capacity, the paper reports that capital expenditures at Oracle, Microsoft, Amazon, Meta and Alphabet rose from about $97 billion in 2020 to more than $400 billion in 2025 and are projected to exceed $800 billion in 2026, above their combined operating cash flow for the first time. Its figure puts 2026 at $800.5 billion of capex against $707.1 billion of operating cash flow, which computes to about 113 percent.

Why a CRE operator should read past the headline

The trillion-dollar total is mostly chips. By the paper’s own breakdown, the facility and power infrastructure are about one-third of a campus’s initial cost and the compute hardware about two-thirds, and hyperscalers tend to point their own capital at the IT equipment. The buildings, shells and power are the layer being moved to third parties. The paper describes developers, REITs, infrastructure funds and private equity building or buying facilities and leasing capacity to hyperscalers, financed by bank mortgages, syndicated lines, private credit and securitization, and it says data centers have become a major institutional real estate asset class. That is the CRE exposure, and the paper’s worked example is Meta’s Hyperion financing in Louisiana. For the financed phase of roughly 2.0 GW and about $30 billion, the paper says Meta sold an 80 percent equity stake to Blue Owl for about $2.5 billion, and the joint venture, Beignet, raised $27 billion of debt in October 2025, rated A+ by S&P, one notch below Meta. The paper puts debt to assets near 90 percent, the debt service coverage ratio at 1.12x, and the yield at 6.58 percent, at least 100 basis points over what it estimates Meta would have paid unsecured, or more than $5 billion of extra interest over the financing’s life.

The lease terms are where a landlord’s underwriting changes. According to the paper, Meta holds a sequence of five four-year leases beginning in 2029 and running to the bonds’ 2049 maturity, may terminate some or all of the campus at each renewal, and in that case must cover any shortfall between sale proceeds and a contractually specified minimum value. Under current GAAP, the paper says, neither the future leases nor that residual value guarantee sits on Meta’s balance sheet before it takes effect, even though one of the two will. It cites Moody’s estimate of roughly $970 billion of hyperscaler lease commitments, about $660 billion of them for leases not yet on balance sheet, and says Meta and BlackRock’s 960 MW Sopaipilla project in El Paso, Texas used a nearly identical structure for $12.3 billion of A+ bonds in July 2026. It adds two market signals. The 36-month rolling beta of data center REITs, measured on FTSE Nareit index returns, has risen from roughly 0.5 to around 1, which the author reads as data centers behaving less like defensive infrastructure and more like part of the same risk complex as AI stocks. And under its central assumptions, the 2025 to 2032 buildout needs about $3.7 trillion of annual revenue by 2032 to earn a 10 percent unlevered return at a 50 percent operating margin, roughly $6.9 per billed GPU-hour at 80 percent utilization.

The workflow PSV would run on a data center exposure

The artifact worth building is an exposure register for any data center an owner holds, lends against or is bidding, one row per asset, assembled from documents rather than marketing. Inputs: the lease and every amendment; any residual value, construction or completion guarantee; the ownership chart down to the special-purpose entities; a rating agency pre-sale report where the debt is rated; the tenant’s most recent 10-K and 10-Q lease commitment footnotes; and the interconnection and power agreements. Output: columns that answer the paper’s questions for one building. Who legally owns the asset, and who bears demand, refinancing and residual value risk, which the paper argues are no longer the same party. The tenant’s termination and renewal dates. The guaranteed minimum value and who stands behind it. Debt to value and debt service coverage at the property level, not the tenant’s corporate leverage. The share of rent from one tenant. And a line for what is not disclosed, because the paper notes that publicly rated debt is a small share of data center financing and that syndicated bank loans and private credit, which are much larger, publish little. Every populated cell cites a page of a contract or a filing.

The reviewer is the acquisitions or credit lead, with counsel on the guarantee and termination language, and the approval gate is specific: no valuation, loan sizing or exit cap assumption treats a terminable lease with a residual value guarantee as equivalent to a fixed 20-year term until someone has modeled the renewal dates and read who pays the shortfall. An assistant is useful for the volume here, pulling lease commitment tables out of five hyperscalers’ filings, extracting renewal and termination clauses from a lease stack, and flagging where an entity chart has an unexplained layer. It should not decide the probability of a renewal, value a stranded 200 MW shell, or convert the paper’s national scenario into a view on one market. PSV ran no model on this paper, tested no product, and promises no underwriting, valuation or return outcome.

What stays with a person, and what the paper does not settle

The operator read

Finish with the judgment call.

The reported facts are above. Enter your email for PSV's operator conclusion and a year of access to every newsroom brief.

THIS ARTICLEALL PSV BRIEFSNO CARD REQUIRED
Send the operator read

Free. No card. Privacy policy. Unsubscribe anytime.

Dispatch the read

Keep the operator view in your deal room.

CRE AI Instituteby PSVLive

Build the workflow behind this analysis. Train with the operators doing it.

Real deal files, live builds, and production-ready CRE AI workflows inside the CRE AI Institute.

Clear answers

Common questions about Financing the AI Buildout Brookings

How much will the AI build-out cost, according to Brookings?

A Brookings Papers on Economic Activity conference draft by Columbia’s Stijn Van Nieuwerburgh, posted September 23, 2026, projects $10.3 trillion of U.S. investment in data center buildings, power systems, networking and specialized chips from 2025 to 2032, an average of 3.63 percent of GDP a year. The paper compares that with railroads at 2.24 percent of GDP from 1870 to 1890, highways at 1.13 percent from 1956 to 1973 and telecom and fiber at 1.10 percent from 1996 to 2003. The AI figure is a scenario-based projection, not a forecast.

How much of an AI data center’s cost is real estate?

In the paper’s cost model, a representative 200 MW AI training campus costs roughly $8.2 billion: about $2.2 billion for the data center facility, $0.4 billion for incremental power infrastructure and $5.6 billion for the installed IT system. That makes the facility and power about one-third of the initial cost and the compute hardware about two-thirds. The paper says hyperscalers tend to fund the IT equipment themselves while shells, power and related real estate move to project debt, leases and third-party owners.

Why does the paper worry about off-balance-sheet data center financing?

Because leverage and contingent obligations become harder to see. The paper’s example is Meta’s Hyperion financing, where the Beignet joint venture raised $27 billion of debt against about $30 billion of assets, roughly 90 percent debt to assets at a 1.12x debt service coverage ratio, backed by terminable four-year leases and a residual value guarantee that do not appear on Meta’s balance sheet before they take effect. The author says it is premature to call this systemic risk and recommends better measurement and disclosure.
